Update on the development - early May 2026

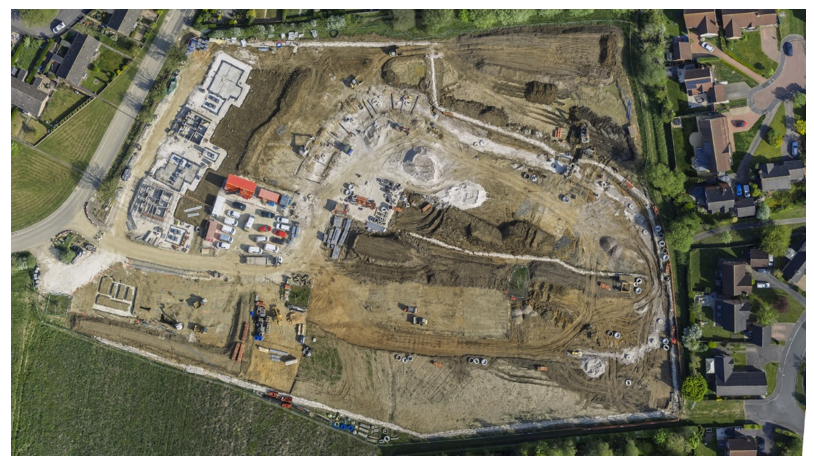

Progress is now going very well, as we progress the first four (frontage to Nettleham Road Plots 1 - 4) houses in to build. We hope to open the show home/sales on site in July this year, with the first people moving in by the end of the year.
Prior to that, it will be a busy summer with onsite infrastructure, key things include (and dates subject to usual caveats).
Installation and connection of the onsite electricity substation by mid-June
• Dropping the overhead cables that cross the site and re-routing underground late June/early July
• Installation of the attenuation tank in June/July
• Installation of the surface water and foul water pump station July/August.
So all in all, a lot going on but, by the end of the summer, the tank will be in, and the site will have its own services.
